Alto protestors arrive in Ottawa with petitions addressed to King, Prime Minister following 100 km walk
The group of protesters began their five-day “Long Walk to be Heard” in East Hawkesbury, aiming to draw attention to concerns with the project.
The Alto high-speed rail line is proposed to run between Toronto and Quebec City, with stops in Peterborough, Ottawa, Montreal, Laval, and Trois-Rivieres.
Earlier this week, members of the group told CTV News they held concerns with the project’s potential economic, environmental and agricultural impacts.
READ MORE > By Adam Beauchemin • CTV News Ottawa • November 12, 2026
Quebec farmers challenge costs of Alto high-speed rail, propose new — slower — plan
Crown corporation says proposal by farmers groups not as simple as it sounds
The study released by Vision Transport and agricultural group Union des producteurs agricoles (UPA) say these savings could be made by modernizing existing tracks.
The study was conducted by Vincent Duguay, a master’s student in research at the École nationale d’administration publique, and Pierre DuSablon, an expert with extensive experience in the rail industry.
It examines two scenarios: a route serving the same 22 stations currently served by Via Rail, and an express route with stops only in major cities.
READ MORE > By Pierre Saint-Arnaud · The Canadian Press · Posted: Nov 12, 2026
AltNo protest group's "LONG WALK
TO BE HEARD" meets at Via Rail
Two AltNo directors, along with several followers, hiked over the past five days from St-Eugène Pavilion, East Hawkesbury, along the length of the Prescott and Russell Recreational Trail to the west 'end point' at Anderson Road, then through Eastway Gardens to their meeting point at Via Rail.
The entourage then walked downtown where they joined the "Stop Bill C-39 National Day Of Action" protest in front of the Prime Minister's office.
Group walking 100 kilometres to Ottawa raising concerns over Alto high-speed rail project
A group of concerned citizens from the group AltNo is now walking along the proposed line between St-Eugène, Ont. on the Quebec border to Ottawa in the hope of raising awareness of their concerns and to present petitions.
Kristen Muller, a director with AltNo, says they are travelling on the stretch of more than 100 kilometres because they’ve spent months trying to draw attention to their concerns and feel their voices haven’t been heard as the project rolls on.
READ MORE > By Kimberley Johnson • CTV News Ottawa • November 09, 2026
Anti-Alto group protests high-speed rail project

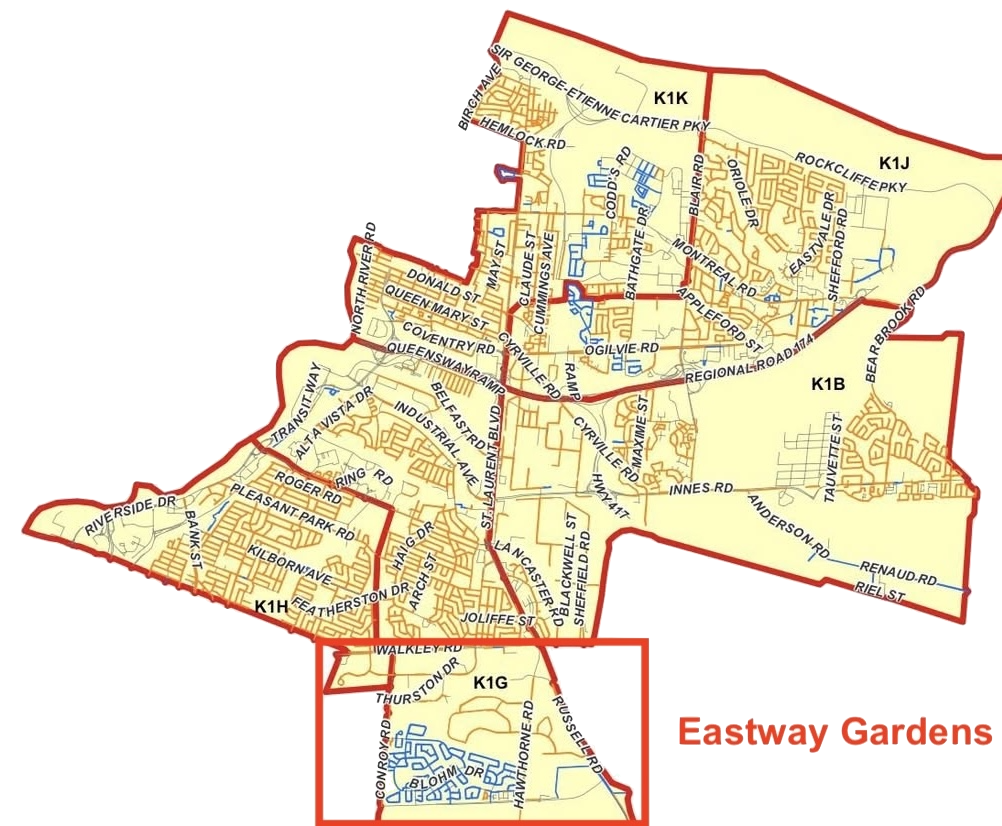

Rural residents take their ALTO fight to [Eastway Gardens] Ottawa with the "Long Walk to Be Heard"
The walk will take place from November 8-12.
Kathleen O’Connell Renaud and Kristin Muller will walk from St. Eugène, East Hawkesbury along the Prescott-Russell Recreational Trail before continuing into Ottawa.
They will present a petition appealing for intervention in the project and real consultation with all communities.
READ MORE > By Lee Griffi • MyBancroftNow • November 6, 2026
Feds look to ‘support accelerating’ construction of Alto high-speed project
Above video includes interviews with City Councillor Marty Carr and Eastway Gardens residents.
The federal budget promises the Liberal government will introduce legislation to “support accelerating the construction” of Alto.
“Legislation will streamline expropriation activities and enable early pre-construction work,” the budget said.
Alto is studying the construction of a high-speed rail line with stops in Toronto, Peterborough, Ottawa, Montreal, Laval, Trois Rivières and Quebec City. Alto is also looking at building a station in Kingston.
READ MORE > By Josh Pringle • CTV News Ottawa • November 06, 2026
Anxiety mounts as Eastway Gardens residents await word on the fate of their neighbourhood
Alto to soon reveal final Ottawa-Montreal high-speed rail route and location of Ottawa station
Photo courtesy Alto
In November, the Crown corporation will reveal the preliminary alignment for the high-speed rail route between Ottawa and Montreal, as well as the location of the Ottawa station. No specific date for the announcement has been given.
As they await word on the future of their small neighbourhood in Alta Vista Ward 18, a growing number of residents fear that if their area is chosen as the location of Alto's 60-metre-wide fenced-in right-of-way, it could displace their homes as it makes its way from the city’s eastern border to Tremblay Station.

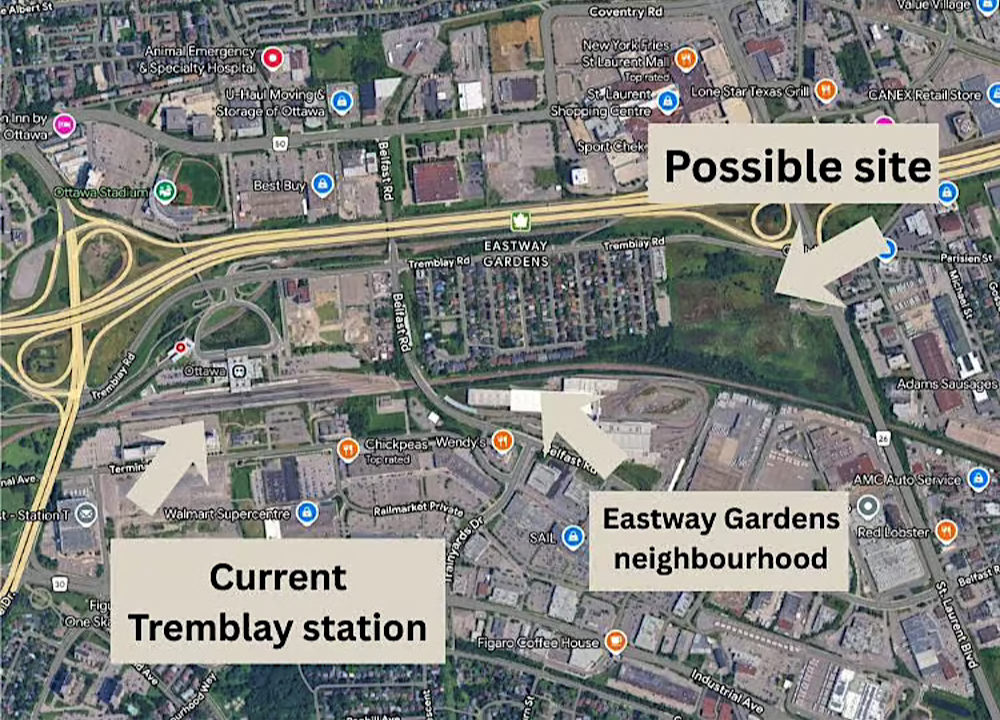

Alto CEO Martin Imbleau has repeatedly identified Via Rail/O-Train Line 1 station on Tremblay Road as the preferred location of Ottawa’s Alto high-speed station. Should this be the case, nearby residents believe they could lose their homes when construction of the station and tracks begins as early as 2029.
Anxiety further escalated when several households reported that they had received letters and in-person visits from Cadence, the Alto representatives seeking permission to enter their properties.
As first reported on this website on September 9th, with a followup story on October 7th, homeowners on Avenue O received an express post 'Permission to Access' letter from Cadence requesting permission to enter their property to conduct “field studies and technical work.” The homeowners denied access to their property. Since then, other residents have stepped forward to report having been approached by Alto representatives. There is no word yet as to how these homeowners responded to these requests. Alto has confirmed that participation is voluntary.
Local media covers Alto’s approaches in Eastway Gardens
Until recently, Alto’s letter campaign and 'door knocker' visits flew under the radar. But on the weekend of October 17th & 18th, journalists and their cameramen visited Avenues O and P seeking homeowners’ views on Alto’s plans. Several articles have since appeared on CBC Radio Canada Ottawa/Gatineau, CBC Ottawa News, and the Ottawa Citizen (read articles below).
Even Alta Vista Coun. Marty Carr was caught off guard. She told CBC Ottawa News that she wasn't informed that Alto representatives would be approaching residents, even though she had previously received updates about its drone surveys that were conducted in Eastway Gardens at the end of July.
Process for expropriating and compensating landowners
Alto has outlined its "Property Acquisition Process" on its website, promising to be “structured, transparent and responsive”. The Frequently asked questions (FAQ) section of their website’s home page addresses questions of importance to those in Eastway Gardens who fear that their homes might be affected.
The Process
- First, the final 60 metre route between Montreal and Ottawa will be announced in November.
- Then properties required within that narrowed corridor will be identified.
- Next, Alto will issue a formal letter to affected owners. Alto notes it will provide a “dedicated representative” for each landowner involved.
- Negotiations will follow.
This CBC News article explains how Alto plans to buy out property owners for its high-speed rail plans:
Offers will be made, a "tailored" timeline created, and appraisals conducted. Once both sides come to an agreement, offers will be signed. Alto expects this to take several months.
The goal is for the tracks to go along existing property lines and for Alto to avoid expropriations, though some will be necessary, Alto CEO Martin Imbleau told The Canadian Press.
"We really want to start with a willing buyer, willing seller," he said.
"That does not mean that the expropriation process will not be used to expedite a transaction, even with a willing seller."
1. Consultation
2. Surveys (on land and via drones)
3. Engineering
4. Cost estimates
Timeline:
- November 2026 - Alto presents results of consultations that compiled over 300,000 comments and suggestions.
- November 2026 - Alignment (final Ottawa-Montreal route) will be presented.
- Final 60 metre, high-speed right-of-way will be fenced in. As in Europe, for example, overpasses and bypasses will ensure road access for farmers. No provincial or municipal roads will be closed. Tunnels and underpasses will allow movement of wildlife and livestock.
- Travel time one hour between Ottawa & Montreal.
- Fall 2026 - Discussions with landowners regarding land compensation, including ongoing discussions with farmers' associations.
- December 2026 - Alto to publish results of environmental studies.
- Spring 2027 - Alignment (Ottawa-Toronto route) to be presented - Kingston stop likely to be added.
- Travel time under two hours between Ottawa & Toronto.
- Travel time under three hours between Montreal & Toronto.
Compensation:
- Based on fair market value
- For loss of productivity for 100 years
- For loss of travel time due to detours
- If landowners don't agree with Alto's appraisals, then they can hire their own appraisers. If Alto's appraisal is proven wrong, then landowners will be compensated for cost of private appraisal.
- CLARIFICATION NEEDED: Imbleau's statement that landowners' third-party appraisals will be compensated only if "Alto's appraisal is proven wrong" appears to contradict Alto’s property acquisition process as outlined in Our Property Acquisition Process which states: "Owners will be given time to review the offer and seek independent legal advice before making any decisions. They may also obtain an independent appraisal of their own. Where more than one appraisal is obtained, both will be considered as part of the negotiation process. Alto will cover reasonable third-party costs related to the acquisition process, including independent appraisal and legal fees."
- If landowners prevent Alto from conducting surveys, then Alto will use historical data, such as utility maps, to gather information.
- If no agreement on terms of compensation can be reached, then expropriation to be considered as a measure of last resort.
VIEW VIDEO INTERVIEW > CBC Ottawa • July 22, 2026
Group opposed to Alto weighs in with warnings
"According to our MP, landowners can expect to receive ‘property offer packages’ in November. Which means Alto will be buying properties before the business case is released, before the impact study is completed and before the project receives final approval,” says spokesperson Kristin Muller.
"It is important for people to understand that Bill C-15 changed the expropriation act. If they do not accept the ‘offer’ Alto has said they are prioritizing ‘willing buyer, willing seller’ agreements,” Muller warned. “Expropriation will follow at the end of 2027. There is no way to fight the expropriation."
READ: > Bill C-15: Key Changes to the Federal Expropriation Act for High-Speed Rail Projects
Signs like this one have appeared recently at the intersections of Tremblay Road and several Avenues in Eastway Gardens
Homeowners who have received Alto access requests invited to pin their location on map
> Website Staff · Posted: October 23, 2026
Alto surveying properties in Ottawa ahead of impending station, route reveal
Site of planned high-speed rail train station to be announced this fall
Alto, the Crown corporation tasked with building a fully electrified high-speed rail line between Toronto and Quebec City, is set to announce the location of its planned station in Ottawa within the next few weeks.
In Eastway Gardens, which is located just east of the Ottawa Train Station, residents are holding their breath in anticipation their neighbourhood could be chosen.
“It’s the uncertainty of not knowing what’s going to happen,” said Deanna Derby, whose Avenue P home is near Via Rail’s train tracks. “Do you sell your property? Do you wait it out? What kind of compensation would you get? It’s very worrisome.”
READ MORE > Ben Andrews · Ottawa Citizen · Posted: October 20, 2026
Alto eyes up land near Ottawa's Via Rail station, but says no decision made
Crown corporation's representatives visiting residents to carry out studies
Above video includes interviews with Eastway Gardens residents.
The crown corporation confirmed its representatives have been going door-to-door near the station, including along O and P avenues in Eastway Gardens, seeking permission to access private properties to carry out field studies.
For some residents, Alto's presence has them worried about what the project could mean for the neighbourhood.
READ MORE > Cameron Mahler · CBC News · Posted: Oct 19, 2026
